Most construction rework starts weeks earlier, when the scope was never documented, a specification that was passed verbally, or a change order was agreed upon between the client and a sub that never made it back to you.
None of this is visible until the work is done. The framers built the wall to a different dimension. The electrician ran conduit where the cabinet was supposed to go. The tile was installed without the border detail that the client approved.
Getting the subcontractor back takes days. The schedule slips, the client wants answers, and the cost lands on you.

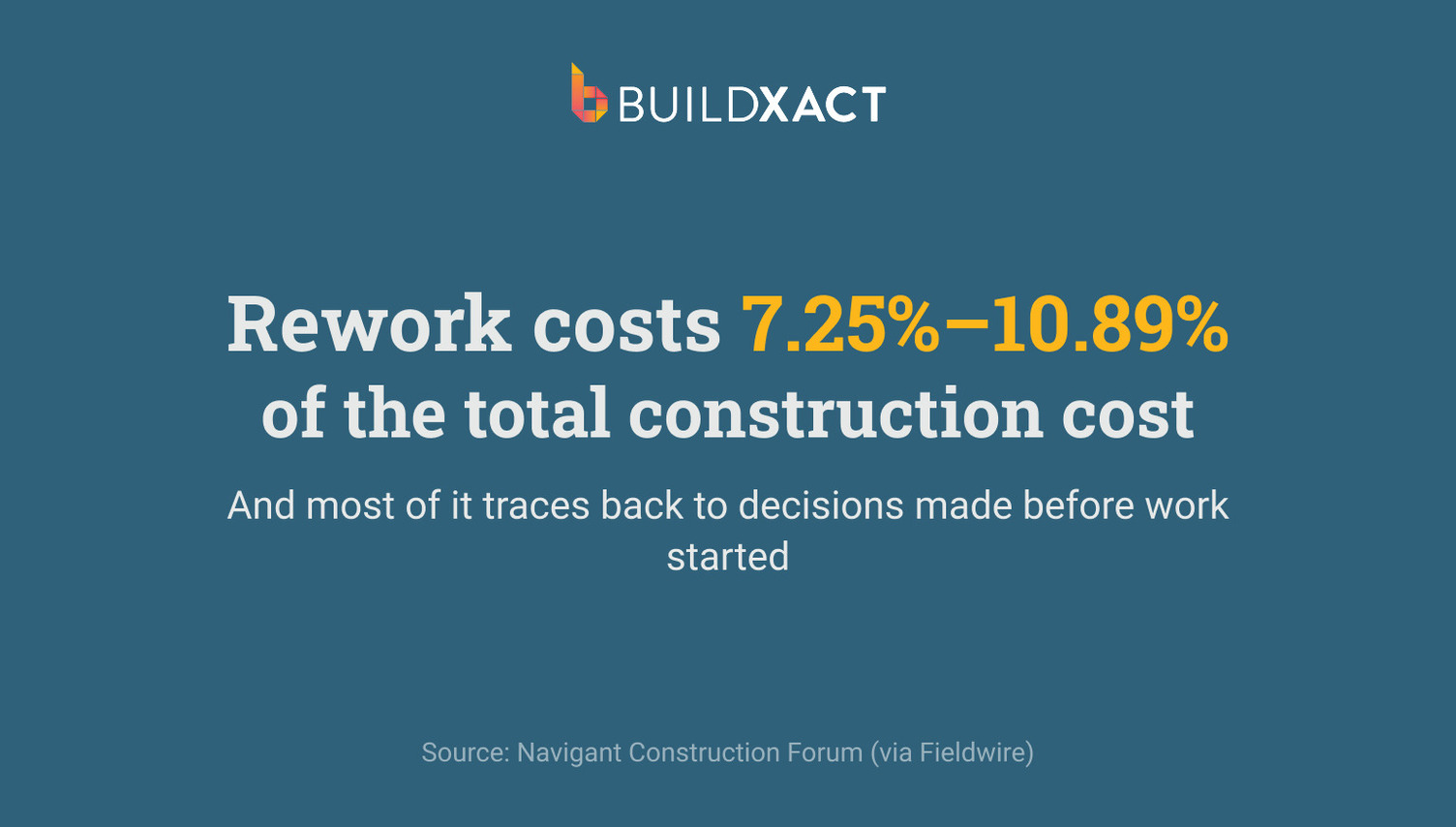

According to the Navigant Construction Forum’s research on rework in construction, rework costs between 7.25% and 10.89% of total construction cost when both direct and indirect costs are included, with a median of 9.07%.
The same research found that rework causes approximately 9.8% schedule growth on the average project.
On a $500,000 job, that is between $36,000 and $54,000 absorbed before you have made a dollar of profit on the next one. Most of it is preventable, but not by inspecting more carefully after the work is done.
This guide explains what construction quality assurance is, how it differs from quality control, and what builders who avoid repeat rework do differently before the first subcontractor arrives.
What Is Construction Quality Assurance?
Construction quality assurance is the decision to define the standard before the job starts, rather than discovering it through on-site rework.
That standard doesn’t appear during construction. It’s set up front, in the scope, specifications, and tolerances the work is expected to meet. If those aren’t clear, there is nothing to check against later.
When that standard isn’t defined, every subcontractor fills in the gaps differently. That’s where rework begins. Quality assurance fixes that by putting the scope, specifications, and tolerances in writing before work begins.
It shows up in decisions made earlier than most builders are used to making:
- Documenting what needs to be built,
- Confirming that materials and subcontractors meet that expectation
- Checking work at points where problems can still be corrected without undoing completed work.
At closeout, it shows up as a record of what was held and what wasn’t, not for reporting, but to carry a better standard into the next job.
You decide on the quality level before the first subcontractor arrives. If the scope, specifications, and tolerances aren’t clear at that stage, every check on site turns into a judgment call.
That’s where inconsistencies show up, rework starts, and costs move without a clear reason.

Quality Assurance vs Quality Control in Construction
Quality assurance prevents defects by defining the standard before work begins. Quality control identifies defects by checking whether the completed work meets the standard.
The difference is when the decision gets made. Quality assurance sets the scope, specifications, and tolerances upfront so the work has a clear target. Quality control happens during and after execution, using inspections and testing to verify whether that standard was met.

The two are connected, but they do not replace each other. Quality assurance sets the standard. Quality control measures the work against it.

| Quality Assurance | Quality Control | |
| Goal | Prevent defects | Identify and fix defects |
| Timing | Before and during the build | During and after the build |
| Activities | Documentation, standards, training, hold points | Inspections, punch lists, testing |
| Ownership | Builder, PM, subs | Inspectors, QC managers, builders |
In most jobs, quality control ends up doing more of the work. Issues are identified during inspections, but many trace back to gaps in scope, specifications, or tolerances that were never clearly defined.
Quality assurance exists to close those gaps before work begins.

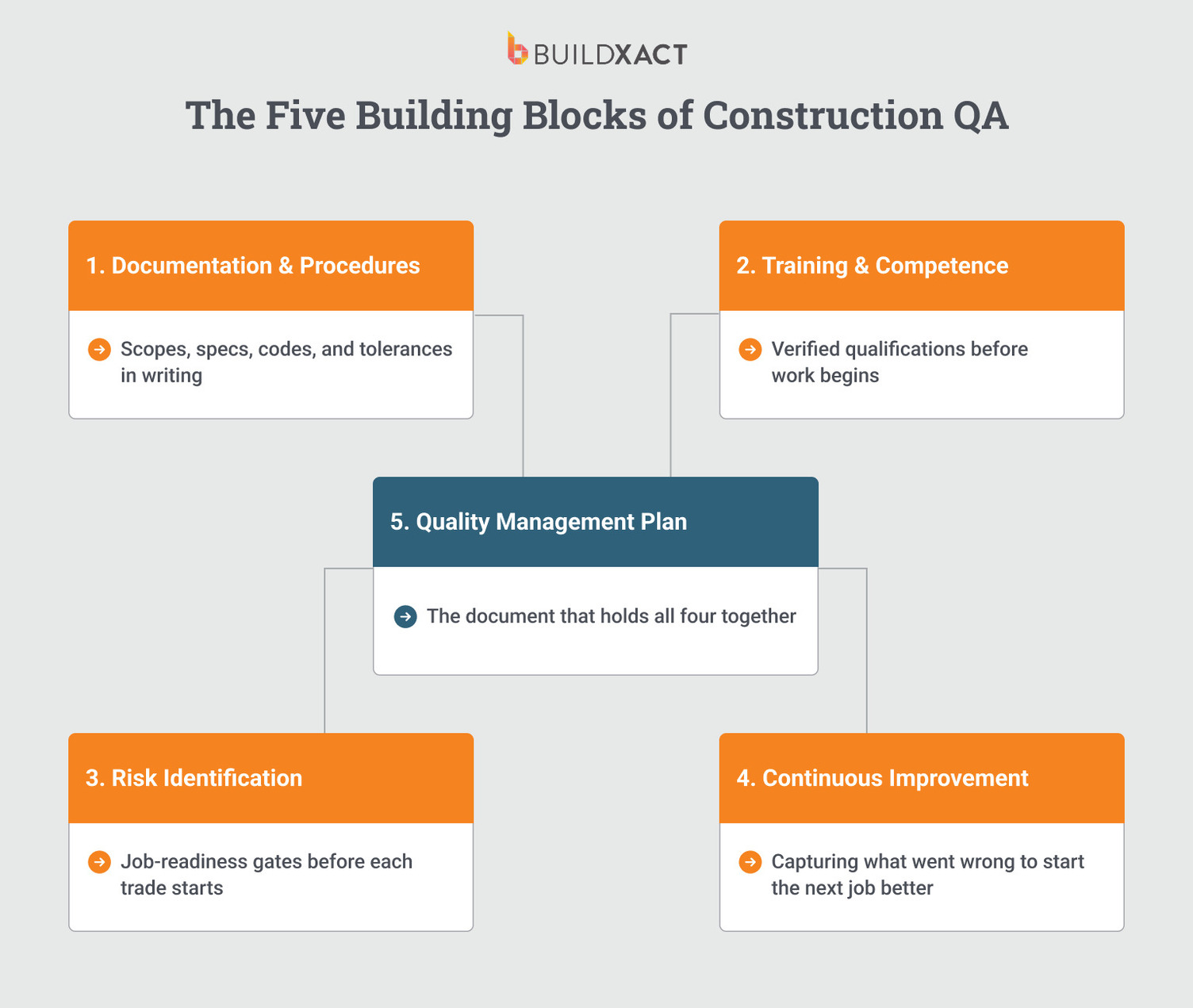

The Five Components of Construction Quality Assurance
Construction quality assurance runs through five components. Each one sets the standard, communicates it, and carries it through the job.

1. Documentation and procedures
The standard is set out in the documents: scope of work, specifications, codes, product requirements, and workmanship tolerances. These need to be clear enough that a subcontractor can follow them without relying on verbal clarification.
Document control ensures everyone is working from the current drawings and specifications, not outdated versions.
2. Training and competence
A standard only works if the subcontractor can deliver it. Before work begins, confirm that each subcontractor is qualified for the specific scope they’re assigned, based on relevant experience, certifications, and prior approvals.
3. Risk identification and management
In residential construction, this is a job-readiness check. Before a subcontractor starts work, confirm that the scope is correct, that the materials are available, and that prior work won’t create conflicts.
Hold points build this into the sequence so that the next phase doesn’t start until the current one is checked and signed off.
4. Continuous improvement
Continuous improvement is how a builder turns a completed job into a better starting point for the next one. Each job should improve the next one. Missed details, scope gaps, and unclear specs get captured, translated into updates, and carried forward into future estimates and checklists.
The value comes from consistency, not occasional lessons learned.
5. Quality management plan
This pulls everything together into a working standard for the job. For most residential builders, this is owned by the builder or project manager, not a separate quality team. If ownership isn’t clear, the standard remains in documents rather than guiding the work.
Why Construction Quality Assurance Breaks Down in Practice
You already understand what quality assurance is supposed to do. Plans, checklists, and standards exist, but once the job starts, decisions shift to calls, texts, and on-site conversations.
Three predictable pressures turn the job into reactive quality control.

Deadline pressure overrides documentation
Fixing something visible feels faster than preventing something that hasn’t happened yet. Under a tight schedule, documenting the standard gets pushed aside, so there’s no time to write it down, walk it through, or confirm alignment before work starts.
So the job begins with assumptions instead of a shared standard. Each subcontractor fills in the gaps based on how they’ve done it before, and the differences only show up once the work is done.
At that point, the decision is already made. The issue is either corrected in the moment, disrupting the schedule, or left to be addressed later.
That “later” rarely happens. By the time rework is scheduled, the crew has moved on to the next job, access is harder, and the cost of fixing it has increased. Instead of being traced back to the missing or unclear standard, the cost is absorbed into overhead.
Once the cost disappears into overhead, the mistake disappears with it. Nothing changes in the checklist, the scope, or the next estimate, and the same issue reappears on the next job.
Scope and standards aren’t written down before work starts
The rework event that ends in a dispute almost always traces back to the same place: nothing was written down before work started.
Without a defined scope, each party fills in the gaps differently. The builder assumes one level of finish. The subcontractor assumes another. The client expects something else entirely. Those differences stay hidden until the work is in place, and by then, they’re expensive to resolve.
This is where most disputes begin:
- “I thought that was included.”
- “That wasn’t in my price.”
- “We’ll need a change order for that.”
At that point, the work is already done or underway, and the scope is being defined after the fact.
The crew pauses while you clarify the scope. The subcontractor prices the gap, and the client questions the increase. What should have been agreed before the work started is now negotiated mid-job, under time pressure.
A vague estimate is not a standard, but a dispute waiting to happen.
Relationship pressure absorbs the cost
In residential construction, many quality failures do not immediately escalate into formal disputes.
You absorb them by fixing the issue, discounting the invoice, or covering the extra work because pushing back would damage the client relationship or stall the job.
That keeps the project moving, but it also hides the real problem. You don’t document the scope gap or missing standard, so the same issue shows up again on the next job, and then again after that.
So nothing was solved in an effort to absorb quality failures, and the costs come back later as rework, margin loss, scope arguments, and jobs that are hard to close out without too much back-and-forth.
How Residential Builders Set the Quality Standard Through the Estimate
The difference between a job that runs without rework and one that ends in rework and disputes is set before work starts, in the estimate.

A complete estimate does more than price the job. It defines the scope, sets the standard, and carries that standard through the bid, subcontractor pricing, and job budget. When it’s clear, the build runs to it. When it isn’t, the gaps show up later as change orders, disputes, and untraceable costs.
The estimate defines the scope and standard
A vague estimate leaves too much open to interpretation. Missing or unclear line items force subcontractors to make assumptions, and those assumptions don’t match what the builder or client had in mind.
The issue doesn’t show up immediately because work continues. But across phases, those gaps compound into margin loss and scope that has to be renegotiated mid-job.
A defined estimate removes that ambiguity. Subcontractors price against specific line items instead of filling in the gaps. The client sees what has been allowed for before work starts.
When a question comes up on site, the answer is already in the documents, not in memory or on a phone call.
The estimate carries the standard through the job
The estimate doesn’t stop at pricing. It becomes the reference point during the build.
Work orders, purchase orders, and scope confirmations carry the standard forward, ensuring every subcontractor works from the same information. If the work doesn’t match, the record shows what was agreed and when.
This is what turns the estimate into a working document. The builder does not need to be present for the standard to hold, because it exists in the documents the job runs on.
The estimate is enforced and improved over time
Checks built into the sequence reinforce that standard. A hold point at the end of each phase ensures the work is reviewed before the next trade begins, preventing one mistake from being built over by the next.
After the job is complete, the estimate improves. Missed line items, unclear specs, and scope gaps are captured and carried forward into the next job.
Over time, the estimate becomes harder to misread and more accurate to build from. It stops being a one-time document and becomes the system that sets the standard across every job.
How Construction Software Fixes Where Manual QA Processes Break
The five practices above don’t fail because the system holding them together is manual.
A scope gets confirmed on a call, but is never written down. A checklist exists, but it isn’t used consistently across jobs. A change gets approved in a message thread, but never makes it back to the job file. The standard exists, but the record doesn’t.
That gap between what was agreed and what was recorded is where quality assurance breaks down. When the record is incomplete, every dispute becomes a reconstruction of what happened rather than a reference to what was approved.
Construction software closes that gap by making the record part of the work itself. Checklists, approvals, and communication are captured as the job runs, not recreated afterward.
Standardizing quality through checklists
In manual processes, checklists depend on your discipline. They get skipped under time pressure, applied differently across jobs, or live in separate documents that aren’t referenced on site.
Software turns the checklist into a working tool. The standard is built into the job, completed on site, and tied to photos, timestamps, and sign-offs. Quality stops depending on memory and starts running as a repeatable process.
Keeping approvals and communication tied to the job
Most quality disputes aren’t about what happened. They’re about what was agreed.
In a manual system, that record is scattered across calls, texts, and emails. When something goes wrong, there’s no single place to verify what was approved.
With software, updates, approvals, and site communication are logged directly against the job.
Using the Buildxact Onsite mobile app, crews capture progress, photos, and sign-offs in real time, synced to the main project file.
That changes the conversation from “what do you think was agreed” to “here’s what was approved and when.”
Turning QA into a system, not a habit
Manual QA relies on consistency from the builder and the team. Under pressure, that consistency breaks.
Software removes that dependency. The process runs the same way on every job because the system enforces it: checklists are completed, approvals are recorded, and documentation is stored where the work happens.
The setup cost includes creating checklists, and onboarding subcontractors takes time. But for builders who already understand the importance of QA, software is what allows that standard to hold across every job without relying on memory or follow-up.
Getting Construction Quality Assurance Right Starts Before Work Begins
Quality control is what you do when something goes wrong. Quality assurance is what you do, so it does not.
The failure pattern that produced the wall built to the wrong dimension, the conduit run through the cabinet space, and the tile installed without the approved border, none of that started on site. It started before the first subcontractor arrived, in the documentation gap that gave them no standard to work from.
The builders who close that gap are more specific before the build. They write down the standard, build it into the bid, confirm it with every sub before work starts, and check at the stages where problems get buried. And they carry what they learn into the next job.
When those five practices run through a single system, quality stops depending on whoever shows up that day and starts running as a repeatable standard across every job. That is what construction quality assurance looks like in practice, not a management layer added to a project, but the decision architecture built before it starts.
To see how this works in Buildxact, start for free or sign up for a demo to keep your estimate, scope, work orders, and site records connected, so the standard you set before the job starts remains visible as work progresses.
